Commercial Solar Panel Installation in Lucknow 2026 — Process, Cost & Documents

Commercial solar panel installation in progress on a Lucknow office building rooftop by Rudransh Solartech installation team

Commercial Solar Panel Installation in Lucknow (2026): Complete Process, Cost, Documents & What to Demand from Your Installer

📅 Published: May 2026 🔄 Updated: 23 May 2026 🔧 Installation Guide ✅ MNRE Certified Process

Quick Answer — Commercial Solar Installation in Lucknow 2026

Commercial solar panel installation in Lucknow takes 3–15 days of physical work (depending on system size) plus 15–60 days for UPPCL commercial net metering approval. Cost is ₹40,000–₹55,000 per kW fully installed. The installation process involves site survey, system design, ALMM panel procurement, mounting structure fabrication, panel installation, inverter commissioning, and UPPCL net meter application — all managed end-to-end by Rudransh Solartech.

10–50kW install 3–7 days
100kW+ install 7–15 days
UPPCL LT metering 15–45 days
UPPCL HT metering 30–60 days
Cost ₹40K–₹55K/kW

Getting commercial solar installed in Lucknow is a fundamentally different project from residential installation — in complexity, documentation, timeline, and what can go wrong. Business owners who approach commercial solar with residential expectations often face costly surprises: UPPCL rejections, structural issues, protection relay failures, and vendors who disappear after installation. This guide gives you the complete, accurate picture of what commercial solar installation in Lucknow actually involves — step by step — so you can evaluate vendors, ask the right questions, and get the installation done correctly the first time.

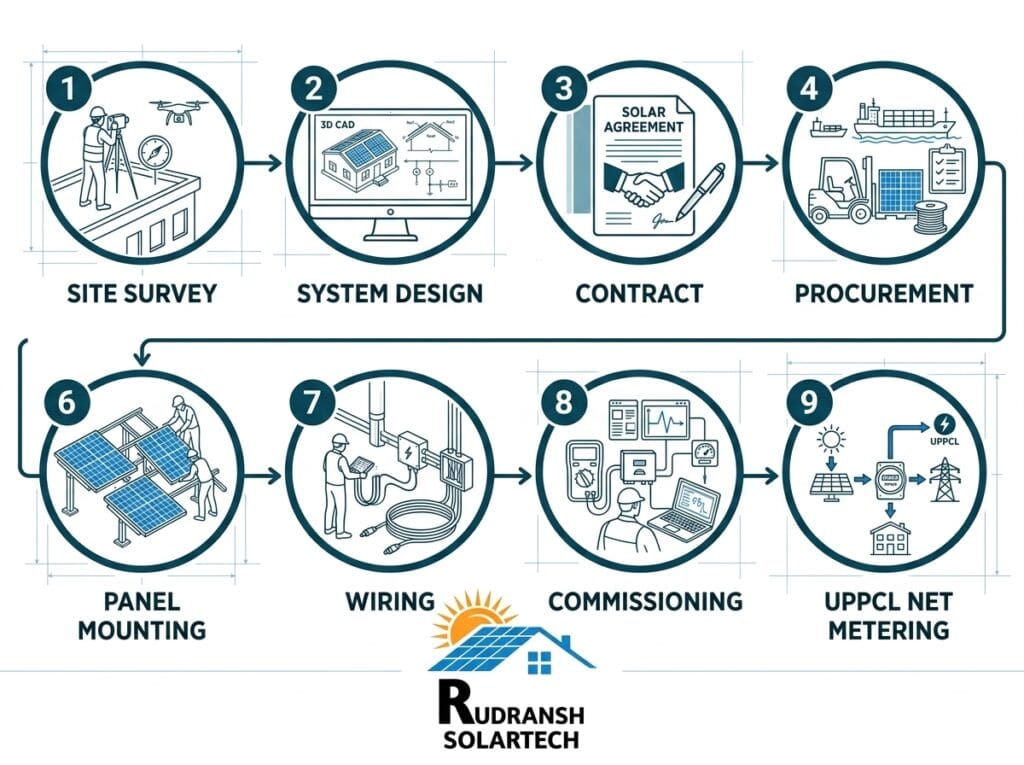

1. Complete Commercial Solar Installation Process in Lucknow (Step-by-Step)

1

Detailed Site Survey & Load Analysis

Our commercial engineer visits your property with a roof measurement tool, shadow analysis software, and a handheld irradiance meter. We measure the exact available roof area, map obstacles (water tanks, exhaust fans, HVAC units), conduct a shade analysis hour-by-hour, and review your last 12 months of electricity bills to build a load profile — including shift patterns, peak demand, and power factor.

⏱ 1 full day | Cost: FREE
💡 Bring your last 3 UPPCL bills and your sanctioned load letter to the site meeting — it saves a follow-up visit.
2

System Design & Engineering Package

Based on site data, we prepare a complete engineering package: scaled roof layout showing panel positions, single-line electrical diagram, inverter sizing calculation, DC string design, cable sizing calculation, earthing layout, lightning protection design, and a generation simulation report showing expected monthly/annual output. This document is also required for UPPCL submission.

⏱ 3–5 days | Delivered in writing before any payment
3

Quotation, Contract & Advance Payment

You receive a fully itemised written quotation: panel brand + model + wattage + ALMM number, inverter brand + model + warranty, mounting structure specification, cable specification, earthing design, protection equipment, SCADA monitoring (if applicable), net metering documentation support, and payment terms (typically 60% advance, 40% on commissioning). The contract specifies penalty clauses for project delays.

⏱ Quotation: 24 hours | Advance: 60% of project value
💡 Never pay more than 60–70% advance before material delivery. Any vendor asking for 100% upfront is a red flag.
4

Material Procurement & QC Inspection

We procure ALMM-listed commercial-grade solar panels, commercial three-phase inverter (string or central), hot-dip galvanised or aluminium mounting structure (designed to withstand Lucknow’s Wind Zone 4 — 39 m/s basic wind speed), 6–10mm² UV-rated DC cables, AC distribution panel, protection relay (for HT connections), surge protection devices, earthing material, and monitoring hardware.

⏱ 7–14 days after advance | We QC inspect all materials before dispatch
5

Civil & Structural Preparation

For flat RCC roofs: PCC/concrete pedestals are cast for ballasted mounting, or anchor bolts are drilled and chemically anchored. For metal sheet roofs: Z-purlins are clamped to roof ribs. For asbestos roofs: structural reinforcement may be required per assessment. Inverter room is identified and AC/DC cable conduit pathways are marked. All civil work is done with minimal disruption to ongoing business operations.

⏱ 2–3 days
6

Panel Mounting & Electrical Installation

Our certified commercial installation team mounts the full panel array — working in parallel teams for large systems to compress the timeline. DC wiring is run in UV-resistant conduit from panels to junction boxes, then to the inverter room via dedicated cable trays. The inverter(s) are wall-mounted, AC output is connected to the facility’s distribution board through a dedicated solar incoming feeder with appropriate MCCB protection. Full system earthing and lightning protection are installed.

⏱ 3–10 days depending on system size (50–500kW)
💡 We schedule heavy rooftop work during non-peak production hours where possible to minimise operational disruption.
7

Commissioning & Performance Testing

Before handover, we conduct: DC open circuit voltage test on all strings, insulation resistance (IR) test on all DC cables, inverter synchronisation with UPPCL grid, protection trip test (over-voltage, under-frequency, anti-islanding), generation logging for 2–4 hours under live solar conditions, and SCADA/monitoring platform setup with client login access.

⏱ 1–2 days full commissioning
8

UPPCL Commercial Net Metering Application

We prepare the full UPPCL net metering application package: completed application form, single-line diagram (signed by electrical engineer), inverter test certificate, panel ALMM certificate, site installation photos, earthing test report, and load flow study (required for HT connections). We submit to your UPPCL division office and follow up at every stage — sub-divisional inspection, divisional approval, and net meter installation.

⏱ Submission: 2 days | UPPCL approval: 15–60 days
9

Handover, Training & Documentation

On project completion, you receive: as-built drawings, all warranty documents (panel + inverter + structure), operation and maintenance manual, SCADA login credentials, emergency contact protocol, and a 1-year workmanship warranty certificate from Rudransh Solartech. We train your facility manager on the monitoring app and basic troubleshooting.

⏱ Half day | Your system is now fully operational

2. Roof Type Guide — Commercial Solar on Different Lucknow Rooftops

Lucknow’s commercial buildings have four common roof types. Each requires a different mounting approach:

🏢

Flat RCC Terrace

Most common in Lucknow offices and hospitals. Ballasted (concrete block) or chemically anchored mounting. No waterproofing issues if done correctly.

✅ Easiest to install | Standard cost
🏭

Metal Sheet (GCI) Roof

Common in Lucknow factories and warehouses. Z-purlin clamping system — no drilling through the sheet. Structural assessment needed.

✅ Compatible | +5–10% cost vs RCC
🏗️

Asbestos (ACC) Roof

Older factory roofs. Requires careful structural assessment. Brittle sheets need reinforcement before panel load. Special mounting brackets used.

⚠️ Needs assessment | +10–20% cost
⛰️

Sloped / Truss Roof

Some commercial buildings have sloped RCC or tiled roofs. South-facing slope is ideal for solar. Custom rafter/purlin mounting required.

✅ Good for solar | +8–15% cost
⚠️ Waterproofing Warning for Flat RCC RoofsIf your RCC terrace has existing waterproofing (bitumen felt, polyurethane coating), drilling anchor bolts for panel mounting must be done with chemical anchors and sealant to preserve the waterproofing layer. Always ask your installer specifically how they prevent roof leaks — it’s a critical quality differentiator between professional and amateur commercial installers.

3. Documents Required for Commercial Solar Installation in Lucknow

DocumentPurposeWho Provides It
UPPCL Electricity Bill (latest 3 months)Verify consumer number, sanctioned load, connection category (LT/HT)You
GST Registration CertificateFor commercial GST billing of installationYour business
Company / Firm PAN CardFor invoicing, and Accelerated Depreciation documentationYour business
Property Ownership Proof / LeaseConfirm right to install on the rooftopYou / Landlord
Authorised Signatory Aadhaar + PANFor UPPCL net metering application signatoryMD / Owner / Authorised person
Cancelled ChequeFor any vendor-related financial settlementYour business bank account
Sanctioned Load Letter (UPPCL)Confirms your connection’s maximum permissible solar system sizeUPPCL (we help you obtain this)
Single Line Diagram (SLD)Required by UPPCL for net metering approvalPrepared by Rudransh Solartech
Load Flow Study (HT connections only)Required for high-tension connection net metering approval at UPPCL Division levelPrepared by Rudransh Solartech
Structural Assessment Report (metal/ACC roofs)Confirms roof can support panel loadPrepared by our structural engineer
📋 We Prepare 70% of These Documents for YouThe SLD, load flow study, structural report, installation photos, inverter certificate, and ALMM panel certificate are all prepared by Rudransh Solartech as part of the project. You only need to provide your UPPCL bill, company registration documents, and property proof.

4. UPPCL Commercial Net Metering — LT vs HT Connections in Lucknow

Commercial and industrial UPPCL consumers in Lucknow fall into two categories — Low Tension (LT) and High Tension (HT) — and the net metering process differs significantly:

FactorLT Commercial (LMV-2)HT Industrial (HV)
Typical BusinessOffices, shops, small factories, schools (below 75kW demand)Large factories, hospitals, malls (75kW+ demand)
Max Solar SystemUp to sanctioned load (typically 10–100kW)Up to contract demand (typically 50kW–1MW+)
Application Approving AuthorityUPPCL Sub-Divisional Officer (SDO)UPPCL Executive Engineer / Superintending Engineer
Documents Required Extra (HT)Load flow study, protection relay specification, SCADA connectivity
Inspection byUPPCL JE / AEUPPCL AE + EE joint inspection
Approval Timeline15–45 days30–60 days
Net Meter Type3-phase bi-directional digital meterHT bi-directional meter + CT/PT metering
Who Handles This at Rudransh✅ Our LT metering team✅ Our HT electrical engineering team
🔌 The Most Common Cause of UPPCL Commercial Net Metering Rejection in LucknowSubmitting an incomplete Single Line Diagram — missing protection relay details, wrong MCCB ratings, or no anti-islanding specification. Our engineering team has a 100% first-submission approval rate for LT connections and 94% for HT connections in Lucknow because we prepare documentation to UPPCL’s exact current requirements — which change periodically and differ by division office.

🔩 Get Your Commercial Solar Installation Quote in Lucknow

Free site survey, complete engineering design, and itemised quote — delivered within 48 hours. We handle everything from panels to UPPCL net metering.

5. 10 Things to Demand from Your Commercial Solar Installer in Lucknow

  • Written engineering design package — Scaled roof layout, SLD, inverter sizing calculation, and cable sizing calculation — before signing any contract. If a vendor can’t provide this, they are not a genuine commercial installer.
  • ALMM certificate for the specific panels being quoted — Not just a brand name. The exact model number must appear on the government’s ALMM list. Ask for the ALMM approval number and cross-check it.
  • MNRE empanelment certificate with their vendor ID — This is required for subsidy-eligible installations. Even for non-subsidy commercial projects, MNRE empanelment signals a verified, accountable vendor.
  • Wind load compliance confirmation — Lucknow falls in Wind Zone 4 (basic wind speed 39 m/s per IS 875 Part 3). Your mounting structure must be designed to withstand this. Ask for the structure’s wind load rating in writing.
  • Protection relay specification for HT connections — If you have an HT connection, ask specifically what protection relay brand and model is being installed. This device prevents your solar system from damaging the UPPCL grid and is required for HT net metering approval.
  • SCADA / monitoring system included for systems above 50kW — Without remote monitoring, you won’t know if a string stops performing for weeks. Insist on cloud-based generation monitoring with real-time alerts.
  • Waterproofing warranty for roof penetrations — If your RCC terrace has waterproofing, ask how anchor penetrations are sealed. Get a written commitment that the installer will repair any leaks caused by their work for at least 1 year.
  • Complete earthing test report — Earthing resistance must be below 5 ohms per IS 3043. Ask for the earth resistance measurement (megger test) report at handover. This is a safety requirement, not optional.
  • Minimum 1-year workmanship warranty in writing — Separate from manufacturer warranties. The installer must back their own labour and commissioning work. Get this on company letterhead.
  • Committed timeline with penalty clause — Your solar system generates value every day it runs. If an installer misses the commissioning date by 4 weeks, you lose 4 weeks of electricity savings. A professional installer will agree to reasonable project timeline commitments in the contract.

6. Commercial Solar Maintenance After Installation in Lucknow

A commercial solar system is a production asset — it needs structured maintenance to deliver its promised 25-year performance. Here’s what changes after your system goes live:

Monthly Monitoring Checklist (Do It Yourself)

CheckHow to CheckWhat to Look For
Daily generation vs expectedSCADA dashboard / inverter appGeneration should be within 10% of simulation on clear days
String-level performanceString monitoring in SCADAAny string generating <80% of others on same inverter = issue
Inverter error codesInverter display + SCADA alertsAny persistent error or daily trip should be reported immediately
Panel surface cleanlinessVisual inspection from groundDust / bird droppings / shadow from new obstruction
UPPCL net meter readingCompare export kWh to inverter generation logImport and export should balance with your consumption

Rudransh Solartech Commercial AMC Options

AMC PackageIncluded ServicesAnnual CostBest For
Basic AMC2 site visits/year, visual inspection, connection check, earthing test₹8,000–₹15,000/year10–50kW systems
Standard AMC4 visits/year, panel cleaning (2×), inverter health check, SCADA review, report₹15,000–₹35,000/year50–200kW systems
Comprehensive AMCQuarterly visits, panel cleaning, IR thermography, all minor repairs included, priority 24hr response₹35,000–₹80,000/year200kW+ systems
💡 AMC ROI CalculationA comprehensive AMC for a 100kW system costs ₹50,000/year. A single missed fault (shading from bird nesting, loose DC connection) can reduce generation by 5–10% — worth ₹57,600–₹1,15,200 annually. The AMC pays for itself by catching even one such issue per year. For production-critical businesses, an AMC is not optional — it is basic asset management.

7. Red Flags: Signs Your Commercial Solar Installer Is Cutting Corners

  • No engineering design package before contract signing — A professional commercial installer produces the roof layout and SLD before asking for money. Signing a commercial solar contract without seeing the engineering design is the number one mistake Lucknow business owners make.
  • Using residential-grade string inverters for 3-phase commercial loads — Single-phase residential inverters connected to 3-phase commercial distribution boards create phase imbalance and can trip your facility’s main protection. Commercial buildings need 3-phase inverters.
  • Skipping surge protection devices (SPDs) — Lucknow experiences severe lightning storms during monsoon. Without SPDs on the DC array and AC output, a single lightning strike can damage your entire inverter and monitoring system. SPDs are not optional on commercial systems.
  • No cable management — wires run loose on rooftop — Exposed, unsupported DC cables on a factory rooftop degrade within 2–3 years from UV, heat, and mechanical stress. All commercial DC cables must run in UV-resistant conduit or cable trays secured every 400–600mm.
  • Installing panels directly over waterproofing without sealing anchor points — Common shortcut that causes roof leaks 6–18 months after installation. Always verify that penetrations are chemically anchored and sealed with appropriate waterproof mastic.
  • No commissioning test documentation — A genuine commercial installation produces commissioning test reports: DC VOC measurement, IR test, protection trip test, and initial generation log. If you don’t receive these at handover, you have no baseline to compare future performance against.
  • Subcontracting to unknown third parties without your knowledge — Some vendors in Lucknow take the contract and subcontract the actual work to daily-wage labour teams with no solar training. Ask specifically: “Is your installation team employed by you or subcontracted?” and ask for their NABL-certified electrician’s license.

📍 Commercial Solar Installations Across Lucknow

We have delivered commercial solar installations in all major business and industrial zones of Lucknow:

Chinhat Industrial Area Gomti Nagar Extension Vibhuti Khand Hazratganj Amar Shaheed Path Kanpur Road Industrial Sitapur Road Faizabad Road Sultanpur Road Mahanagar Sector H Aliganj Vrindavan Yojana
🏢 Rudransh Solartech 📍 Lucknow, Uttar Pradesh 📞 +91-91960 39515 💬 WhatsApp Us ⏰ Mon–Sat: 9 AM – 6 PM
🏅 MNRE Empanelled
⚡ UPPCL LT/HT Authorized
🔩 100+ Commercial Installs
📋 Full Engineering Package
🔧 24–48hr Service Response

8. Frequently Asked Questions

How long does commercial solar panel installation take in Lucknow?
Physical installation takes 3–7 days for 10–50kW systems and 7–15 days for 100kW+ systems. After installation, UPPCL commercial net metering approval takes 15–45 days for LT connections and 30–60 days for HT (industrial) connections. Rudransh Solartech manages the full UPPCL process end-to-end so you don’t have to follow up with government offices.
Can commercial solar be installed while my business is running?
Yes, in most cases. Rooftop mounting work happens externally on your roof and does not interrupt ground-floor operations. The final electrical connection — connecting the inverter to your distribution board — requires a brief planned shutdown (typically 15–30 minutes) during a low-production window. We coordinate this with your facility manager in advance to minimize disruption.
What happens to my commercial solar system during UPPCL power cuts?
On-grid commercial solar systems automatically shut down during UPPCL power cuts — a mandatory safety requirement (anti-islanding protection) required by UPPCL and inverter certification standards. For businesses where continuous power is critical (hospitals, cold storage, data centres), we recommend a hybrid system with battery backup or solar + DG integration, which keeps critical loads powered during outages.
What is the commercial solar system warranty in Lucknow?
A properly installed commercial solar system from Rudransh Solartech comes with: 25-year linear performance warranty on panels (from the panel manufacturer), 5–10 year product warranty on inverters (brand-backed), 5-year corrosion warranty on mounting structure, 1-year workmanship warranty from Rudransh Solartech, and annual AMC options for ongoing maintenance support.
Can Rudransh Solartech install solar on my metal sheet factory roof in Lucknow?
Yes. We have installed commercial solar on colour-coated steel (GCI) factory roofs across Lucknow’s industrial areas. We use a Z-purlin clamping system that attaches to existing roof ribs without drilling through the sheet — preserving your roof’s waterproofing integrity. A structural assessment is conducted before every metal roof installation at no extra charge.
9-step commercial solar installation process in Lucknow by Rudransh Solartech — from site survey to UPPCL net metering
Ready to Go Solar?

Get Your Free Solar Survey + ₹1,08,000 Subsidy

Book a free site survey with Rudransh Solartech. Our engineer will visit your home, assess your rooftop, and calculate your exact savings — at zero cost.

✅ No obligation  •  ⭐ 4.9/5 Google Rating  •  🏆 1500+ Installations

Government Registered Company PM Surya Ghar Portal Enlisted 4.8★ Google Rating 1500+ Happy Families Serving All Uttar Pradesh 0% Down Payment EMI Available Tier-1 Panels • 610–625W Per Panel Government Registered Company PM Surya Ghar Portal Enlisted 4.8★ Google Rating 1500+ Happy Families Serving All Uttar Pradesh 0% Down Payment EMI Available Tier-1 Panels • 610–625W Per Panel
